We’re building to continue making wine for many generations!

The winery is designed to fit beautifully in our area and is a high-tech production hall at the same time, to produce the quality wine we’re so proud of. The building is constructed in the form of a square and consists out of four houses. The new cellar is equipped to handle dubble the capacity that we are currently operating at. We are constructing the building in order to continue producing wine for many generations. Our new winery is a project that we started in November 2021. The construction of the building will be finished before the harvest of 2022.

The winery we are building is 200 m², that will serve several purposes in our vineyard. In addition to the production of wines, the top floor of the house will serve as an event hall. The space will be used for wine tastings, art exhibitions and other special events. More information on how to book the event space will be revealed later!


The progress

November/December 2020 - Digging the new cellar

Here our builders are making room for the new building to be constructed. They have also made the foundations in December.

January 2021 - Constructing the walls

Next, the support for the walls is placed and concrete is being laid.

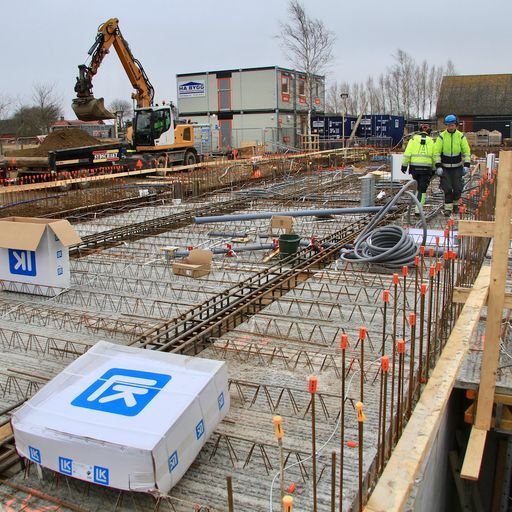

February/March 2021 - Building the floors

Then the levels of the building are constructed by layering steel and concrete.

April 2021 - Applying the wooden frameworks

In April the foundations of the roof were laid with wooden frameworks. Here, we also had a look at our soil and water reserve.

May 2021 - Constructing the next houses

More wooden frameworks are attached to build the next part of the house and the water reserve is being constructed as well.

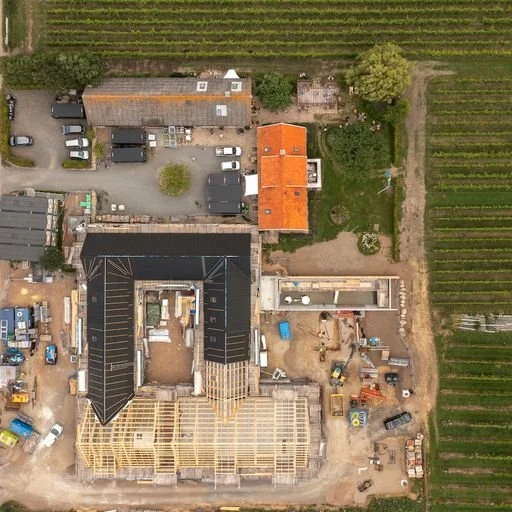

June 2021 - Setting up the roof

The next step was to add the foundations and the panels for the roof.

July 2021 - Applying the metal work and constructing the machine hall

The machine hall was built in July and after, metal was added to the roof of the winery.

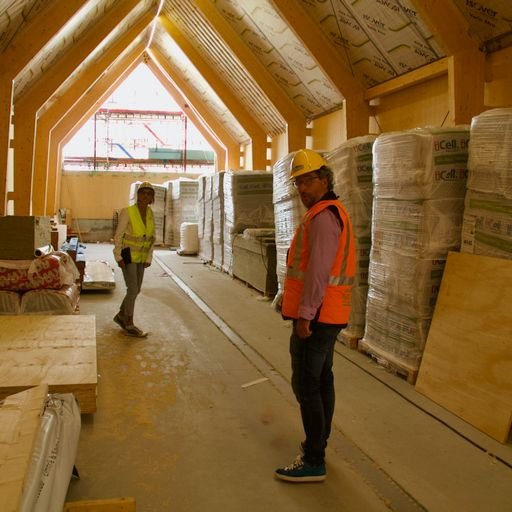

August 2021 - Working on the inside of the building

Work was done on the inside of the winery, both the walls were solidified and wood was applied during this month.

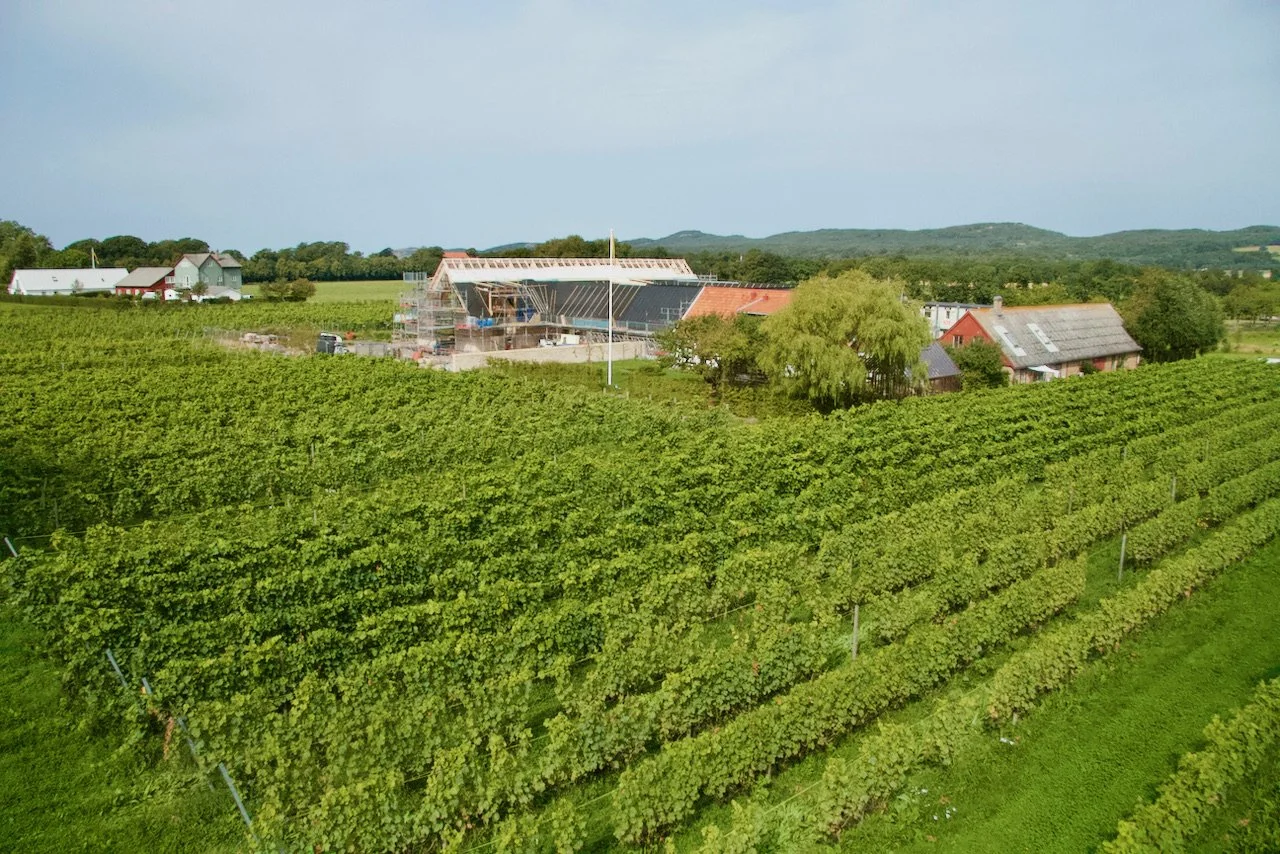

September - December 2021 - Continuing the ongoing process

Great progress was made in these months, both on the inside and the outside of the new winery.

January 2022 - Working inside the winery

More finishing touches are made in January.

February 2022 - Constructing the event hall

The event hall is one of the last steps of the construction, together with the outside of the building.

March 2022 - Putting finishing touches on the event hall

The inside of the event hall is worked on in March. The finish line is getting closer!
